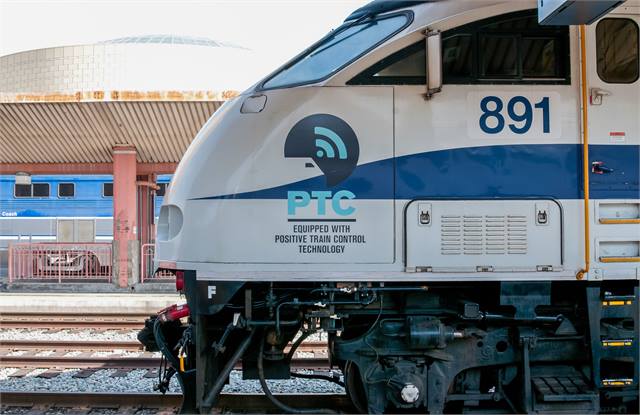

Commuter rail making significant progress on PTC, study finds

Implementation is expected to cost the commuter rail industry more than $3.5 billion in capital expenditure, which includes over $16 million in spectrum acquisition, as well as $100 million annually in additional maintenance costs.

November 17, 2016
Commuter rail making significant progress on PTC, study finds



3 min to read


According to updated analyses done by the American Public Transportation Association (APTA), the commuter rail industry is making significant progress on implementing positive train control (PTC) and is on schedule to meet the congressional deadlines.

According to APTA's analyses, some of the results include:

Ad Loading...
  • 22% of the 3,150 route miles are either in service or in full PTC demonstration awaiting Federal Railroad Administration (FRA) approvals.

  • 27% of the 3,400 locomotives and cab cars are installed with PTC hardware.

  • 40% of the 35 back office control systems are ready for operation.

  • 70% of spectrum has been acquired and 50% of the 1,000 radio towers have been erected.

  • 22% of the 13,000 employees have been trained in PTC.

  • 19% of commuter rail agencies are expected to be 100% PTC equipped by the end of 2016.

"The commuter rail industry has made great strides in implementing positive train control (PTC)," said APTA Acting President/CEO Richard A. White. "This progress on this complex safety technology demonstrates our ongoing commitment to our number one priority of safety."

The delivery of PTC is highly complex, requiring the development of safety critical software; installations on 3,150 miles of track; 3,400 locomotives; 1,000 radio towers; and training more than 13,000 employees, according to APTA.

"The installation of PTC is a heavy lift for the commuter rail industry. From a technical standpoint, PTC was not a mature technology when Congress mandated it in the Rail Safety Improvement Act of 2008," said White. "A number of challenges had to be addressed, not just from the technology aspect, but in costs, scarce qualified resources, and adequate access to track and locomotives for installation and testing."

Douglas Rahden

The APTA analyses was based on surveying APTA members and assessing the quarterly reports submitted to the FRA. It also showed that given the priority of PTC, there remains significant investment backlog for State of Good Repair (SOGR) and expansion projects, including upgrades and replacement to track, bridges, rolling stock, and facilities.

Ad Loading...

PTC implementation is expected to cost the commuter rail industry more than $3.5 billion in capital expenditure, which includes over $16 million in spectrum acquisition, as well as $100 million annually in additional maintenance costs. As of October 2016, spending by the commuter railroads is estimated to be more than $1.5 billion.

Funding remains a critical concern for the commuter rail agencies, all of which are publicly funded. Currently, $75 million has been awarded to commuter rail agencies through federal grants designated specifically for PTC implementation. Additionally, $199 million was authorized by Congress but has yet to be appropriated. Finally, a $967 million loan from the U.S. Department of Transportation was made available to one commuter rail agency for PTC implementation.

"It is urgent that Congress appropriate additional dollars so that the commuter rail industry has the resources to continue their aggressive actions to meet this congressional deadline," said White.
