BART replacing old third rail for a smoother and more reliable ride

The new rail is half the weight of the old and conducts electricity better.

by By Melissa Jordan, BART Senior Web Producer
August 7, 2019
BART replacing old third rail for a smoother and more reliable ride

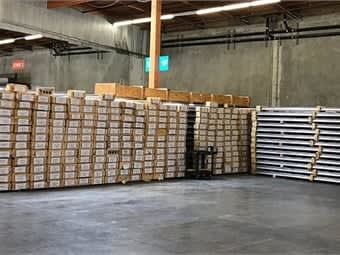

New, stainless steel-capped aluminum third rail segments stacked in a warehouse.

BART

4 min to read


New, stainless steel-capped aluminum third rail segments stacked in a warehouse.

BART

A key part of BART’s Measure RR rebuilding work is renewing power infrastructure, a major upgrade that will improve the rider experience through greater reliability and less down time for repairs.

Along with cable and traction power substation replacement, part of the job is replacing sections of third rail, the electrified rail that powers BART trains.

Stacked high in a chock-full storage warehouse are stainless steel-capped, aluminum third rail segments that will be more efficient and economical. The new rail is half the weight of the old and conducts electricity better.

That means easier and faster installation, because the old rail weighed in at 27 pounds per foot or 810 pounds for a typical 30-foot segment or “stick,” more than twice the weight of the new rail. It takes many workers to handle such a heavy load, and the old rail is also six times stiffer than the new, making it tough to position just right. With the new rail, BART can do repairs more quickly, requiring less down time and inconvenience.

Close-up detail of the new third rail that is stacked in a warehouse waiting to be used.

BART


The warehouse holds some 2,400 sticks of new rail, at 12 pounds per foot, or 360 pounds per stick. That’s light enough to require far fewer workers to handle. There’s a thick aluminum bar to conduct electricity, covered by a tough stainless steel cap for resistance to the countless iron paddles from train cars that slide across its top, transferring power to the train.

“Third rail is an important asset for reliability of the power system and continuous train operation,” said Myat San, BART’s Group Manager for Power and Mechanical Engineering. “The useful life of these third rail segments is about 20 years. As they age, efficiency and performance will be impacted.”

Ad Loading...

RELATED: Powers takes over as 10th BART GM

Back in the 1960s and 1970s, Kaiser Aluminum (no longer in business) supplied all of BART’s third rail for the core system.

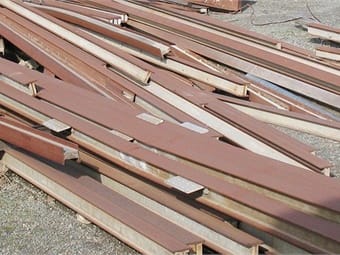

Old Kaiser Aluminum rail, past its useful life, is put into a scrap pile for removal.

BART

There were two styles, a regular one at 4 micro-ohms per foot (an ohm is a standard measure of electrical resistance) and a more conductive version known colloquially as “double-stuff Oreo” at 2 micro-ohms per foot.  The more conductive one was considerably more expensive and used in areas with long distances between traction power substations.

The original third rail was made by standing 30-foot steel I-beams vertically in molds, and pouring in molten aluminum for a strong bond. It was symmetrical top and bottom, so when the tops wore out after about 20 years of use, BART electricians simply flipped them to use the other side. Eventually both sides would wear out and require third rail replacement.

By around 1990, with much of the third rail in high-wear areas at the end of its useful life and with no more Kaiser Aluminum to provide new rail, another manufacturer provided for core system replacements, as well as for new extensions to the BART system such as to San Francisco International Airport. This rail is the heavier, less conductive rail in much of the system today.

A corroded, weather-exposed rail cross-section, left, and a pristine sample.

BART

BART also decided to make all new third rail the thicker aluminum 2 micro-ohm/ft. version—the double-stuff Oreo kind --  to reduce voltage drops and improve train performance between substations. Third rail voltage has direct impact on train performance, and thus it is important to maintain it at acceptable levels.

RELATED: BART team wins APTA Rail Rodeo

Ad Loading...

Several years ago BART tested a new, stainless-capped aluminum third rail product that offered many advantages, and test sections were installed south of Bay Fair Station to see how it performed. After successful tests, BART is moving forward to install it systemwide, replacing legacy 4 micro-ohm rail with the more economical, more conductive, lighter and more flexible new rail. That’s good news for passengers, who can expect a smoother, more reliable ride from the new third rail, the backbone of power for the whole BART system.

“The Measure RR work we are doing to replace substations, transformers, third rail and more, is about reliability and a better experience for BART’s riders,” San said.

BART District voters in 2016 approved the Measure RR infrastructure bond for rebuilding the system. For more information, visit our Measure RR rebuilding website.
